ELWYN PROGRAM SITE · PROJECTS & OPERATIONS

Managing the building between the projects.

At an active 7,000-square-foot program facility, Bright Bond Consulting coordinated planned improvements, responded to incidents and rebuilt small operating systems that were creating recurring problems.

Conditions
Active 7,000-square-foot program facility
Responsibility
Owner-side projects and operations
Range
Improvements, incidents and daily systems
Completed illuminated exterior sign at the Philadelphia program facility at night

A building does not separate itself into neat professional categories.

PROJECT DELIVERY

Visible improvements

  • Two exterior canopy installations
  • Illuminated exterior signage and interior wayfinding
  • Weekend floor polishing and furniture moves
  • Storage planning, purchasing and installation

INCIDENTS & READINESS

Conditions that needed a response

  • Water infiltration assessment and monitoring
  • Damage and remediation documentation
  • Site-specific emergency planning with program staff
  • Warranty records and equipment replacement

OPERATING SYSTEMS

Problems hiding in the routine

  • Parking access and identification
  • Waste stations and handling patterns
  • Shredded-paper service integration
  • Vendor, staff and client communication

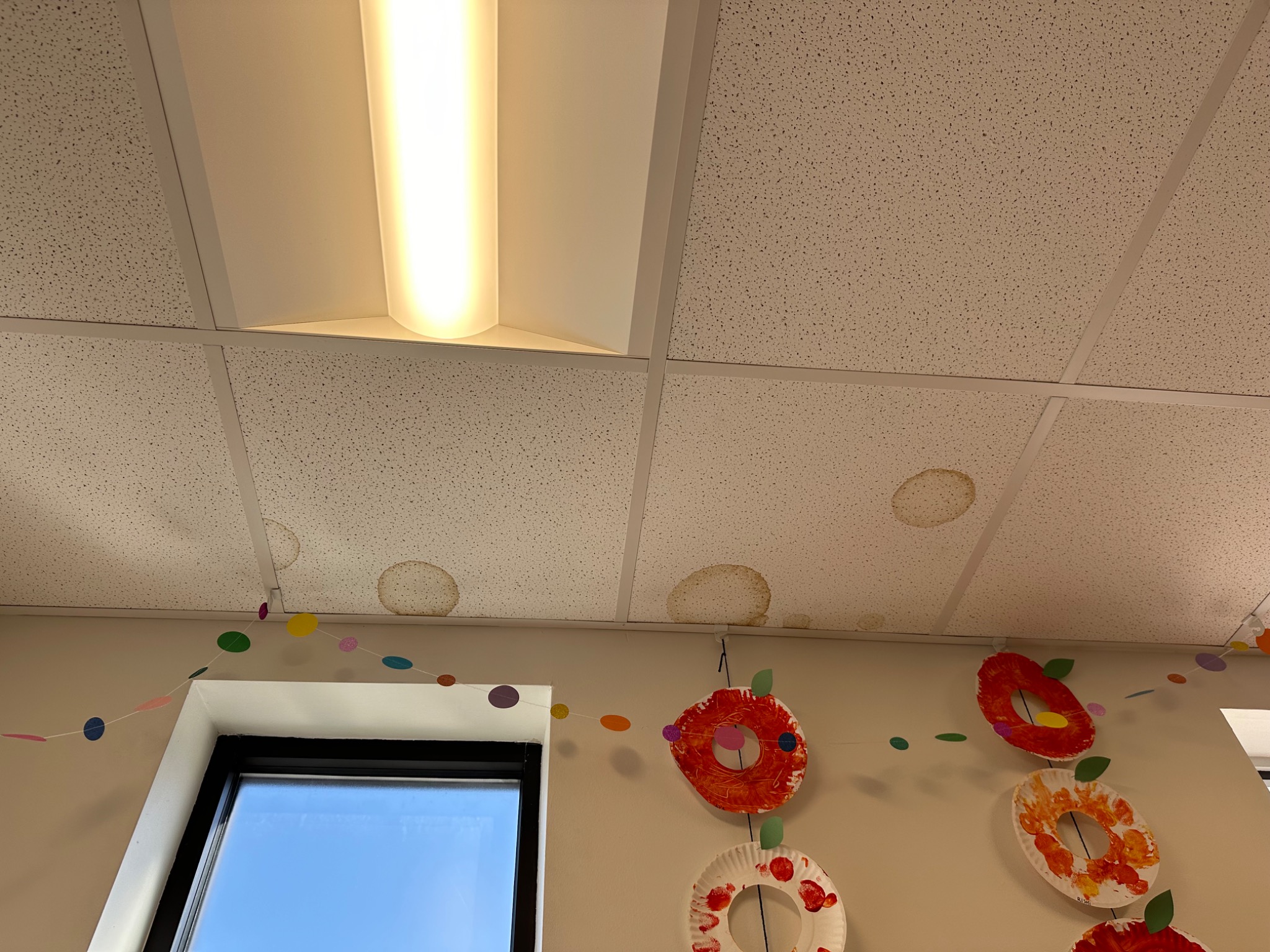

Water staining on ceiling tiles documented during a site walkthrough

Documenting water infiltration so everyone could see the same problem.

Evidence of water intrusion was identified during a walkthrough and required a clearer shared record. Three interior leak locations were mapped against exterior conditions, with photographs and observations organized into a visual report.

Two of the three conditions were resolved. The third persisted. Continued monitoring preserved a record of what changed and what did not after broader attention had moved elsewhere.

Making disruption disappear before Monday.

For an occupied-site floor-polishing project, the visible work was the finish. The management work was everything required to move the building out of the way and put it back together before staff returned.

01

Map the move

Identify what had to move and where it would go.

02

Procure

Hire movers and the floor-polishing contractor.

03

Prepare

Label items, post signs and secure approval.

04

Coordinate

Align staff, vendors and access; respond when cleaning issues arose.

05

Restore

Return everything onsite before the start of the week.

Sometimes the right project is the one no one has named yet.

Parking

Months of back-and-forth around approximately twelve leased spaces

Went to the neighboring lot, built the relationship and established numbered hang tags for each vehicle. The system remains in use.

Waste

Wrong containers, misplaced cans and recurring trash on the floor

Observed the actual pattern, sourced open exterior cans and kitchen step cans, and traced excess volume to shredded paper.

OSHA compliance

Safety requirements applied to observed conditions

Connected the needs and behaviors of the people using the building to practical controls—for example, assessing slip-and-fall risk for low-mobility populations to guide walk-off mat selection and placement.

Value preservation

Recovering value before adding cost

Tracked contract obligations, vendor commitments and warranty coverage; pursued corrections, replacements and existing organizational resources before recommending new spend.

Ground the plan in how the building actually operates.

Emergency planning for this facility was developed with program staff, combining existing client protocols with site conditions, staff responsibilities and daily use.

FEMA Independent Study
Completed
IS-100.C · IS-700.C
In progress
IS-200.C
Other Elwyn work · different Philadelphia site See the protective glazing project →
